How Long Does It Take to Demolish a Commercial Building in Phoenix, AZ?

Phoenix Demolition Co. explains why commercial demolition in the Phoenix metro can take anywhere from two weeks to four months. Building size, structural complexity, permit holds, environmental findings, weather, and the final clearing scope all affect the schedule, so a realistic phase-by-phase plan matters before work begins.

Quick Summary

  • Small retail and single-tenant office projects typically take 2 to 4 weeks from permit issuance through site clearing.
  • Large commercial or industrial projects typically take 1 to 3 months, while high-rise or structurally complex work can extend beyond 3 months.
  • City of Phoenix plan review carries a $390 fee, and many demolition requests have a required 30- or 60-calendar-day hold before work can begin.
  • Pre-1980 hazardous-material findings can add 1 to 3 weeks, while temperatures over 110 degrees and July-through-September monsoons can disrupt active field work.

Commercial Demolition Timeline Highlights

Two Weeks to Four Months

Most Phoenix metro commercial demolition projects fall between two weeks and four months. Small, straightforward buildings may clear soon after permits, while large or complex sites spend more time in review, abatement, controlled sequencing, and debris removal.

Approvals Before Mobilization

Preparation and surveys typically take 1 to 2 weeks, while permit acquisition is often described as 2 to 6 weeks depending on building classification. A required 30- or 60-calendar-day hold, utility disconnect timing, hazardous-material results, or historic-designation review can extend that front end.

Field Work and Final Clearing

Interior strip-out typically takes 3 to 10 days, structural demolition takes 3 days to 3 weeks, and debris removal plus final grading takes another 1 to 2 weeks. Coordinating inspections and equipment mobilization helps keep those phases from sitting idle between handoffs.

Commercial Demolition Schedule Images

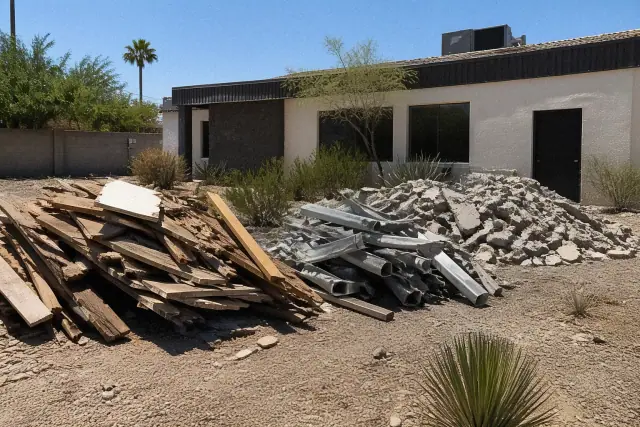

Small Commercial Building Before Site Clearing

Sorted construction waste including wood, metal, and masonry at a jobsite in Phoenix, AZ.

A single-story retail or office building under 10,000 square feet with utilities disconnected and the work area protected shows the kind of site that may finish in 2 to 3 weeks once permits clear.

Multi-Story Demolition Beside Shared Structures

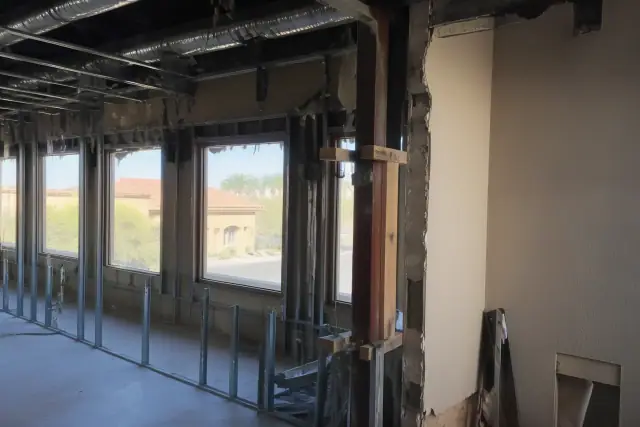

Interior of a demolition site in Phoenix, AZ, showing exposed structural studs and utility conduits.

A multi-story office with elevator shafts, shared risers, or party walls shows why engineering review and controlled sequencing can extend active work to 4 to 6 weeks or longer.

Phoenix Heat and Monsoon Schedule Conditions

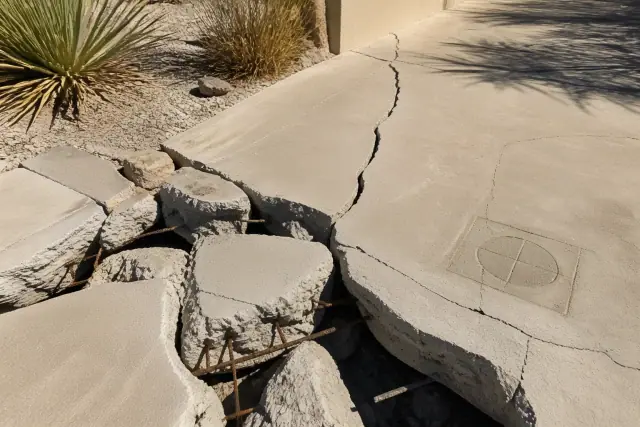

Fractured concrete slab with exposed rusted rebar and moisture-monitoring markings in Phoenix, AZ.

An equipment crew working within shortened heat windows as a monsoon approaches illustrates why July through September weather can interrupt outdoor demolition for a day or more.

Building-Type Timeline Snapshot

Small Retail and Office Buildings

Retail buildings and single-tenant offices under 10,000 square feet generally take 2 to 3 weeks once permits clear, provided access, utilities, and environmental findings are straightforward.

Mid-Size Multi-Story Offices

Mid-size offices with multiple floors, elevator shafts, and HVAC systems tied into shared risers commonly run 4 to 6 weeks because more elements must be isolated and removed in sequence.

Large Industrial and Complex Sites

Big-box retail, distribution centers, and multi-tenant complexes typically take 1 to 3 months from mobilization through final grading. High-rise, implosion, or floor-by-floor selective work can extend beyond 3 months.

Common Schedule Extensions

Buildings constructed before 1980 may need asbestos or lead surveys; asbestos-containing floor tile, mastic, roofing, or pipe insulation can add 1 to 3 weeks for testing and abatement. The Maricopa County Air Quality Department and Arizona Department of Environmental Quality regulate this work under NESHAP standards, while city holds, historic review, extreme heat, and monsoon interruptions can add further time.

Phase-by-Phase Timeline

Project PhaseTypical DurationMain Schedule Driver
Preparation and surveys1 to 2 weeksUtility disconnects, hazmat testing, and site protection planning
Permit acquisitionOften 2 to 6 weeksBuilding classification, plan review, and any required hold period
Interior demolition3 to 10 daysSquare footage and the amount of non-structural material
Structural demolition3 days to 3 weeksStructure, access, equipment, and controlled sequencing
Debris removal and clearing1 to 2 weeksHauling, concrete handling, and final grading

What the Timeline Means

A realistic schedule separates front-end approvals from active field work. The teardown itself-often performed with excavators, hydraulic shears, breakers, grapples, skid steers, and concrete crushers-can be shorter than surveys, utility disconnects, and permit coordination. Scheduling mobilization after inspections helps prevent heavy equipment from sitting idle, while coordinated interior removal, structural demolition, hauling, and grading keep the site moving toward its next use.

Factors That Change the Schedule

Square footage alone is not enough: a 5,000-square-foot strip mall unit and a 5,000-square-foot steel bar-joist warehouse require different sequencing. Multi-story construction, post-tensioned concrete, shared party walls, elevator shafts, and HVAC tied to shared risers add review and protection work; selective demolition is also slower per square foot than open total demolition. Crew and logistics matter-a two-person crew on a 20,000-square-foot warehouse cannot match a full crew with equipment operators and haul drivers working in parallel. Downtown Phoenix and areas near Sky Harbor may also require street-closure and noise-ordinance coordination, while temperatures over 110 degrees or monsoon dust and flooding can shorten or stop outdoor work.

Common Follow-Up Questions

Owners often ask how cost relates to time, whether selective work is faster, what full-service demolition includes, and how to prepare. Commercial demolition in Phoenix and across Arizona generally runs $4 to $25 per square foot, with most Phoenix-area projects between $5 and $12; concrete-heavy sites, below-grade foundations, pool removal, abatement, and long hauling distances can move costs higher. Total demolition is usually faster per square foot than selective work, which uses smaller equipment or hand labor to protect what remains. A full-service scope can include surveys, hazmat coordination, permits, utility disconnects, strip-out, structural removal, concrete work, hauling, and grading, so owners should gather drawings, utility locations, known material history, zoning information, and rebuild requirements early. For comparison, actual demolition of a roughly 1,200-square-foot, 30-by-40-foot house may take 1 to 3 days and the full process may take 1 to 2 weeks, but that residential example does not set a commercial schedule.

Plan the Action

Need a Project-Specific Timeline?

Share the building size, structural type, known hazardous-material history, and desired clearing scope. A site walk and permit-path review can turn the broad range into a phase-by-phase schedule and an itemized estimate separating abatement, demolition, and hauling.
